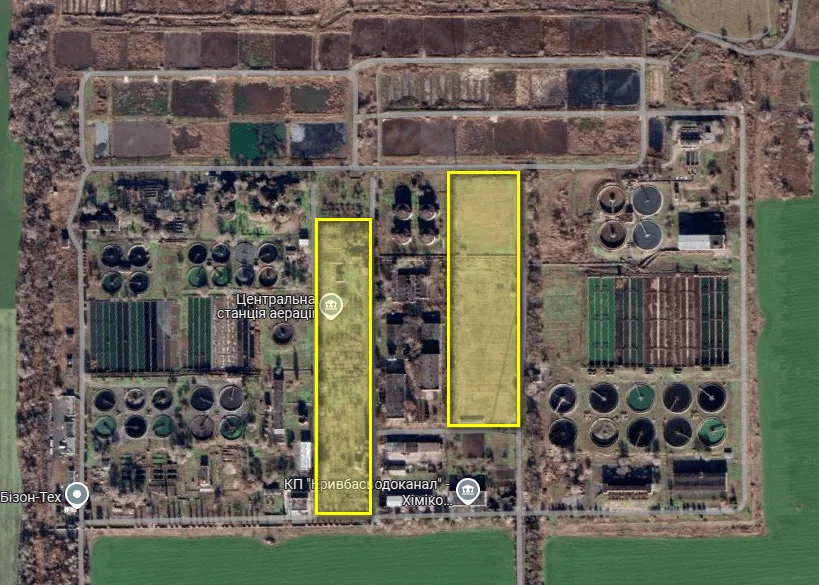

01The system behind the project
The concept places a six-block, 12 MW photovoltaic platform at the Central Aeration Station, a major electricity-consuming water-utility site. Its logic is to match verified daytime generation to treatment demand and only export a demonstrable surplus under a lawful grid and offtake arrangement. The source provides a business case, thirteen-month target and forecast financial indicators, but notes no completed yield, self-consumption or connection study. Functionally the asset supports an agglomeration-critical water service; it does not by itself establish off-grid autonomy.
02How the intervention works
Six nominal 2 MW blocks create physical and financial gates rather than one indivisible plant. Design must integrate module fields, inverters, transformers, protection, revenue-grade meters, SCADA, weather station, earthing, fire access and security with the aeration station’s load and electrical topology. The control scheme should prioritise safe self-consumption, constrain export to the approved connection and preserve treatment operations during faults. Land drainage, shading, geotechnics and cable routes matter. Storage is not evidenced in the source and should not be assumed unless separately sized and justified.
03From concept to an operable asset
First establish solar yield, interval load, land condition, grid capacity and the commercial treatment of self-consumed and exported energy. Complete detailed design and permits for the whole platform, then build the first 2 MW block with independent metering and acceptance criteria. Its measured output, curtailment and interaction with aeration loads should inform release of later blocks. Civil, electrical and grid works can be standardised across six modules, but commissioning remains block-specific. Final performance testing must compare calibrated weather data and actual generation, not only installed nameplate capacity.
04What must be proven before commitment
Before financing, confirm land rights, irradiation dataset, losses, degradation, interval demand, self-consumption share, export limit, grid study, connection cost and settlement rules. Reconstruct the source forecasts for revenue, EBITDA, 14 percent internal return and 7.9-year payback from disclosed tariffs, taxes, OPEX, replacement costs, discount rate and financing. Test curtailment, lower yield, construction delay and tariff change. The decision also needs equipment bankability, warranties, performance ratio, grid-code compliance, environmental and geotechnical review, procurement packages, insurance, operating responsibility and a clear rule for advancing from one block to the next.
05Where a partner can create value
Suitable partners are utility-scale solar developers and EPC contractors with grid-connection, industrial-site and water-utility experience. An independent engineer should validate yield, design, performance guarantees and commissioning data. Inverter, transformer and protection suppliers must offer local service, cybersecurity-compatible monitoring and spare-parts plans. A financier should accept phased drawdown tied to each 2 MW block and measurable acceptance. The water utility, distribution-system operator, land and permitting specialists, insurers and long-term O&M provider must work as one interface team while keeping electrical safety and uninterrupted treatment as controlling constraints.
