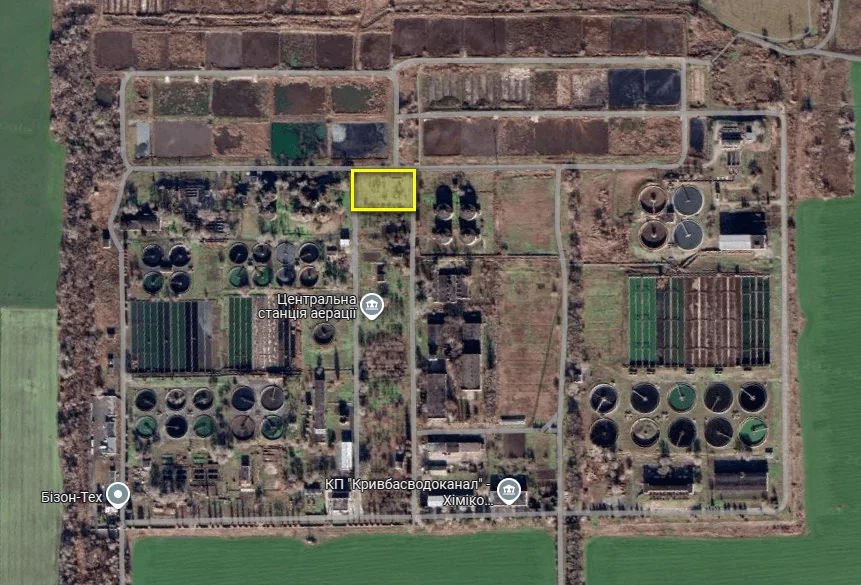

Editorial hero for “0.8 MW Solar Pilot with Honest Economics”: infrastructure, people and the project’s core technical intervention, without implying that the project is complete.
Energy efficiencyIn preparation

Source project ID · project-sun8

0.8 MW Solar Pilot with Honest Economics

A compact solar plant could offset a defined share of daytime utility demand, provided its marginal economics survive sensitivity testing.

Contact for this project

01

Agglomeration relevance

A controlled demonstration for the water-service core and a learning asset for smaller community utilities.
This section is an editorial assessment of functional relevance. It does not change the project owner, beneficiary area or governance stated by the source.

02

Project dossier

The project in operational terms: the system it changes, the intervention logic, the path to delivery and the evidence still required for a responsible commitment.

01

The system behind the project

The 0.8 MW solar concept is small enough to act as a controlled utility pilot, but its source economics are marginal rather than robust: forecast net present value is only €20,000, internal rate of return 5 percent and discounted payback 19 years. Those values leave little cushion for weaker yield, lower self-consumption, curtailment, equipment replacement or financing cost. The page must therefore frame the project as a testable investment hypothesis for the water-service core and possible agglomeration learning asset, not as guaranteed savings, resilience or export revenue.

02

How the intervention works

The technical design should match the PV array, inverters, transformer, protection, metering and SCADA to a clearly identified utility connection and daytime load. Revenue-grade meters must distinguish gross generation, self-consumed energy, import and export. A weather station enables performance-ratio analysis, while the control scheme limits export to the approved value and safely disconnects during grid faults. Layout must address shading, drainage, geotechnics, security, fire access and maintenance. Storage is not evidenced and should not be added rhetorically; if considered, it requires separate load, autonomy, fire-safety and economic analysis.

03

From concept to an operable asset

Treat development as three gates. First, complete at least a defensible yield model, interval load analysis, connection study and commercial settlement case. Second, finalise design, permits and procurement only if the base and downside cases meet an approved threshold. Third, install and commission with calibrated weather, import-export and generation data, then operate through a representative period before scaling the model elsewhere. Acceptance should cover protection tests, actual performance ratio, availability and curtailment. Learning value is real only when assumptions, deviations and maintenance records are transparently documented.

04

What must be proven before commitment

The investment decision must reproduce the stated €20,000 NPV, 5 percent IRR and 19-year discounted payback from disclosed assumptions. Test lower irradiation, soiling, degradation, inverter replacement, downtime, curtailment, lower daytime load, reduced self-consumption, import tariff changes, export price, taxes, OPEX, financing rate and delay. Confirm land, grid capacity, connection cost, settlement eligibility, equipment warranties and decommissioning responsibility. Because the margin is thin, a small change can destroy value; approval needs explicit minimum self-consumption and yield thresholds, not reliance on the headline installed capacity.

05

Where a partner can create value

The best partner is not merely a module vendor, but a developer prepared to disclose the full energy and cash-flow model and accept independent verification. Required capabilities include interval-meter analysis, bankable yield assessment, grid protection, industrial-site EPC, revenue metering and long-term O&M. A financier should understand marginal-return assets and avoid structures whose fees consume the small forecast NPV. The distribution operator, water utility and independent engineer must agree connection and acceptance evidence. Partners should treat the pilot as disciplined learning and must not market unproven backup power, guaranteed savings or sales.

03

How the project creates value

  1. NeedThe concept is small enough for rapid learning but not automatically attractive: its stated NPV is only €20,000 and discounted payback 19 years.
  2. InterventionThe page should foreground yield, self-consumption and tariff sensitivities rather than promise resilience or guaranteed sales.
  3. OutputsA compact solar plant could offset a defined share of daytime utility demand, provided its marginal economics survive sensitivity testing.
  4. BeneficiariesA controlled demonstration for the water-service core and a learning asset for smaller community utilities.
  5. Expected resultExpected effect: A compact solar plant could offset a defined share of daytime utility demand, provided its marginal economics survive sensitivity testing.

04

Evidence dashboard

Solar capacity0.8Target
Annual revenue119000Forecast
Net present value20000Forecast
Internal rate of return5Forecast
Discounted payback period19Forecast

European value lens

Transparent economics, proportionate investment, renewable energy and evidence before scale.

05

Indicative launch scenario

The dates refresh automatically: the scenario begins on the first day of the next month and preserves the source-defined project duration and relative stage sequence.

Scenario start
Scenario completion
  1. 01

    Yield, load and connection development

  2. 02

    PV installation

  3. 03

    Testing and operating baseline

Scenario dates support planning only. They are not evidence of an approved calendar, procurement or financing commitment.

06

Source identity and readiness

Customer
initiated by Kryvyi Rih City Council
Performer
Department for Energy Management and Implementation of Energy Saving Technologies, Department of City Infrastructure Development, CE “Kryvbasvodokanal”
Project year
2024
Readiness
Requires development
Funding required
0,611 mln EUR
Source target term
11 months
Detail status
Active

07

Project context from the source

Optimised derivatives of the source project imagery; each asset retains its provenance.

08

Contact for this project

Support the next verified step of this project with technology, expertise, finance or partnership capacity.

This site collects no messages and stores no personal data. The button opens the original project page on the regional investment portal in a new tab, where the responsible team and its contact details are published.

Source captured and verified on 24 August 2026

Open original project page ↗
